Data Center Technical Due Diligence (TDD): The 6-Pillar Site Audit & Red-Flag Checklist

Direct Answer Block: Data center technical due diligence (TDD) is an independent engineering assessment performed on behalf of institutional lenders or infrastructure buyers to evaluate the physical, electrical, mechanical, and civil risks of an operating or newly completed facility. It reconciles contractual capacity claims against primary utility records, physical equipment inventories, and site hydrology to formulate binding Conditions Precedent (CP) and financial escrow holdbacks before loan syndication or commercial acquisition.

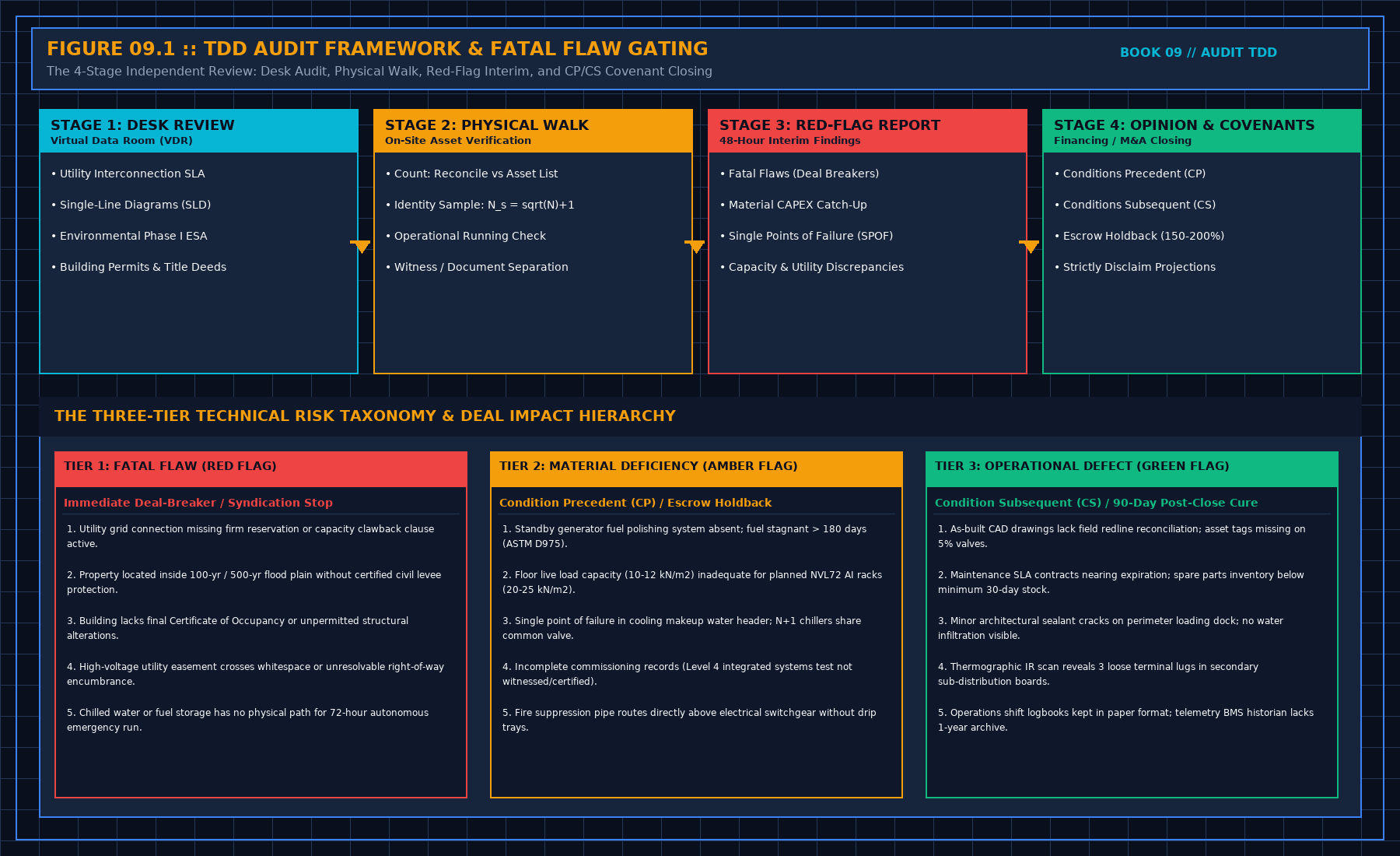

Figure 1: Technical Due Diligence Audit Framework & Fatal Flaw Gating
Figure 1: Technical Due Diligence Audit Framework & Fatal Flaw Gating

When an infrastructure fund or private equity syndicate underwrites hundreds of millions of dollars to acquire a data center campus, the investment memorandum always boasts "Tier III concurrent maintainability," "dual diverse utility feeds," and "high-density AI readiness."

The Independent Engineer's job is not to echo the marketing deck. The Independent Engineer's job is to walk the physical plant, inspect the unpaved utility trenches, pull a fuel thief sample from the bottom of bulk diesel tanks, and verify whether the facility will survive when the grid collapses tonight.

1. The Four-Stage TDD Lifecycle & Risk Taxonomy

A professional technical due diligence audit proceeds through four disciplined operational stages:

The Three-Tier Risk Hierarchy

2. Utility Substation Diversity: The Single-Bus Illusion

Developers frequently present two separate utility power account numbers as proof of grid redundancy. In reality, both feeds often share a single point of failure:

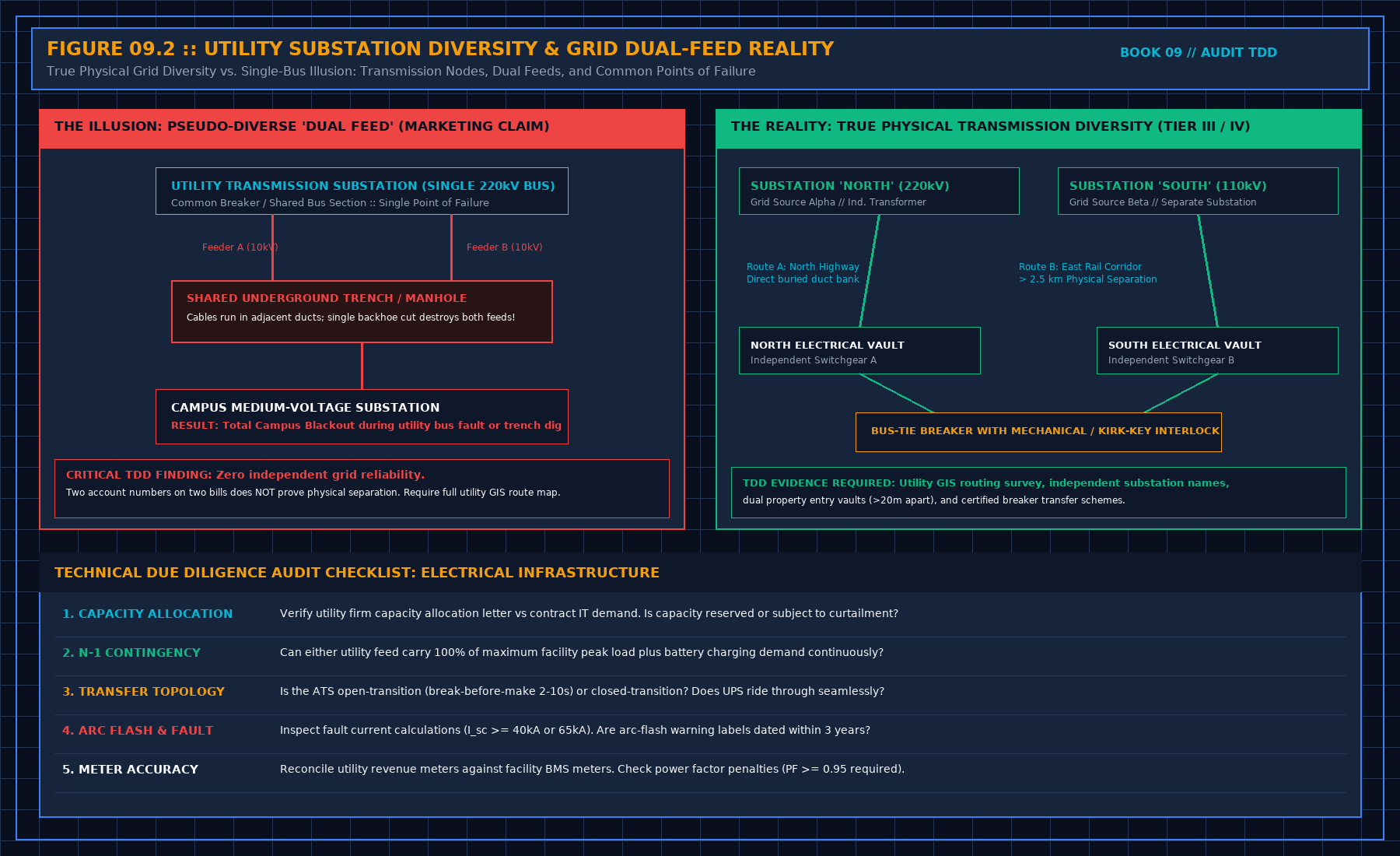

Figure 2: Utility Substation Diversity & Grid Dual-Feed Reality
Figure 2: Utility Substation Diversity & Grid Dual-Feed Reality

The Pseudo-Diverse Trap

As illustrated in Figure 2, developers often pull two medium-voltage cables (10 kV) from the exact same primary utility transmission substation busbar. Even worse, both cables are frequently routed through the same shared trench or street manhole outside the property boundary.

A single municipal excavator strike or manhole fire cuts both circuits simultaneously, plunging the entire data center into a total blackout.

The True Physical Diversity Standard

Under institutional underwriting guidelines (IEEE Std 141 and GB 50174 Class A), true transmission grid diversity mandates:

3. Civil Hydrology: The 500-Year Flood Plain Mandate

While commercial office buildings rely on the 100-year flood plain (1.0% annual exceedance probability), mission-critical data center financing demands adherence to the 500-Year Base Flood Elevation (0.2% annual exceedance probability):

$$Q = C \times I \times A$$

Where Q is peak runoff (m³/s), C is runoff coefficient (0.90 for paved data center roofs/yards), I is rainfall intensity (mm/hr), and A is catchment area (m²).

4. Standby Fuel Autonomy & Fuel Quality Physics

A facility cannot claim Tier III or Tier IV concurrently maintainable autonomy without an auditable, unshared on-site fuel reserve providing at least 72 hours of continuous full-load generation:

$$V_{\text{fuel}} = N_{\text{gen}} \times \dot{m}_{\text{fuel}} \times t_{\text{run}} \times 1.15$$

For a 20 MW IT load supported by 10 standby diesel generators (2.5 MVA each, burning 540 L/h at 100% load):

$$V_{\text{fuel}} = 10 \times 540\,\text{L/h} \times 72\,\text{h} \times 1.15 \approx 447,120\,\text{liters} \quad (\approx 448\,\text{m}^3)$$

The Stagnant Diesel Threat (ASTM D975 / D2709)

Ultra-Low Sulfur Diesel (ULSD) stored in underground tanks degrades within 6 to 12 months. Moisture condensation creates an anaerobic environment where bacteria metabolize hydrocarbons, producing acidic asphaltic sludge.

When generators start during a grid outage, this bottom sludge is drawn into high-pressure common rail (HPCR) injectors operating at 2,000 bar, seizing them in under 15 minutes.

TDD Field Action:

5. Structural Floor Loading for NVL72 AI Racks

Liquid-cooled AI superclusters impose extreme mechanical stresses that legacy enterprise data centers cannot bear:

Facility ClassUniformly Distributed Load (UDL)Concentrated Caster Load (Ppoint)AI Compatibility
Legacy Enterprise5.0–8.0 kN/m² (500–800 kg/m²)≤ 2.5 kNIncompatible
Hyperscale Cloud10.0–12.0 kN/m² (1,000–1,200 kg/m²)≤ 3.5 kNStandard CPU only
AI Supercluster (NVL72)18.0–25.0 kN/m² (1,800–2,500 kg/m²)≥ 4.5 kN per casterMandatory for NVL72

An NVL72 rack weighs up to 1,800 kg operational. Rolling this mass across raised access flooring produces dynamic point loads exceeding 6.5 kN.

Frequently Asked Questions (FAQ)

What is the difference between a Data Center TDD and a Phase I ESA?

A Phase I Environmental Site Assessment (ESA, ASTM E1527) audits only hazardous materials, historical soil/groundwater contamination, and chemical liabilities. A Technical Due Diligence (TDD, ASTM E2018) evaluates the entire physical infrastructure: utility electrical diversity, mechanical chiller redundancy, structural floor load capacity, emergency fuel autonomy, and operational compliance.

How is a Condition Precedent (CP) enforced in data center financing?

A Condition Precedent is a mandatory legal covenant in the credit agreement that must be fully cured before lenders authorize initial debt drawdown. If a defect cannot be physically cured before closing, lenders enforce a financial escrow holdback—typically reserving 150%–200% of the engineer's estimated remediation cost in an escrow account released only after re-inspection sign-off.

Can an Independent Engineer certify facility capacity based on utility application letters?

No. A utility application or pending permit represents potential future capacity, not firm present capacity. The Independent Engineer must only certify capacity supported by fully executed, firm, uncurtailable utility allocation agreements and installed physical electrical switchgear.
