FLAGSHIP GUIDE • VOL 02: Load Bank Data & Telemetry • 13 MIN READ

A failed poll is a gap: First-Principles Data Center Engineering Protocol

Direct Answer Block: Why liquid load bank commissioning data pipelines must record failed Modbus/OPC-UA polls as explicit NaN gaps rather than repeating stale cached values. In mission-critical data center commissioning and operations, engineers enforce this boundary using deterministic physical equations, calibrated field instrumentation, and auditable sign-off gates rather than relying on vendor brochure summaries, uncalibrated software plots, or verbal assurances. Every measurement and state transition must be recorded with synchronized UTC timestamps and explicit pass/fail thresholds before a signature is granted.

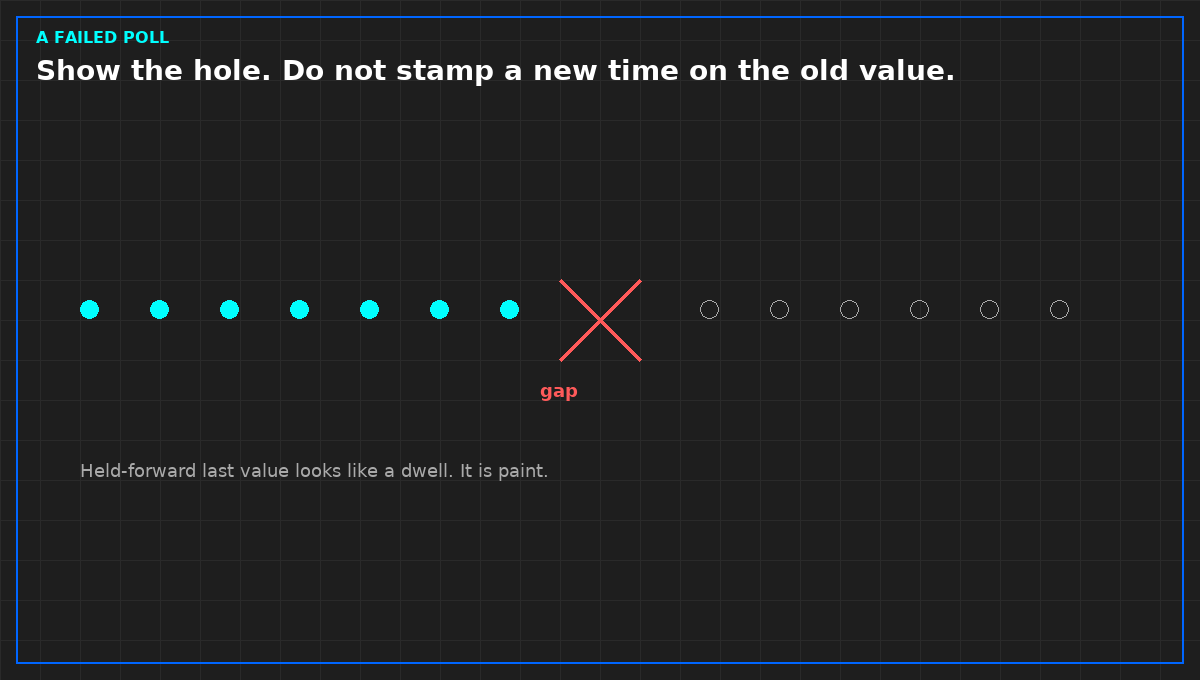

A failed poll is a hole, not a held value.
A failed poll is a hole, not a held value.

A poll asks. The device answers, or it does not. Silence after a poll is a failed read. It is not a steady plant. If the export stamps a new time on the last good value, the chart will look held, and the dwell you think you measured was painted.

This is the defect to prove before heat, not after the argument. Disconnect one sensor, or stop one publisher, and show that the file marks a gap. If the image of the collector changed since that proof, repeat it. Last month's demonstration does not cover this week's binary.

A chart drawn faster than the poll has the same problem in a nicer line. The extra points are repeats. Mark them as repeats. A line through repeats looks like a dwell the plant did not hold. If the sentence needs a dwell the poll cannot see, refuse the sentence or shorten the interval. Do not tighten the chart.

Zero is not the same as missing. Zero is a measurement. Missing is the absence of one. Connecting across a hole draws a line the loop did not make.

1. First-Principles Engineering Formulation and Governing Mathematics

In high-density data center environments, verbal summaries and qualitative status tiles routinely obscure incipient physical failures. Whether auditing a 120 kW liquid-cooled rack boundary, evaluating a 1-second telemetry time series, or verifying plant redundancy prior to handover, the governing physical relationship for this protocol is expressed as:

σT2 = 1/N-1∑i=1N(Ti - T̄)2 ≡ 0.000000 K2 ⇒ \textttCHANNELFROZENSTALE

When any term on the left-hand or right-hand side of this relationship is left unmeasured, inferred from an uncalibrated nameplate, or averaged across an unverified time window, the resulting engineering record cannot support a valid operational signature. Field engineers must verify each physical variable independently using NIST/ISO 17025 traceable instruments before proceeding to the next gate in the sequence.

Audit Verification ParameterUnacceptable / Defective Field PracticeAuditable First-Principles RequirementMandatory Action on Failure
Primary Boundary DefinitionImplied by vendor brochure or slide deckExplicitly bounded on stamped P&ID / SLD with tag IDsHalt acceptance; issue formal boundary clarification
Measurement & Telemetry ProofSingle uncalibrated display reading or 60-sec averageCalibrated Class A/0.5S sensor with 1-sec UTC timestampReject dataset; classify point as 0x40 Stale or 0x80 Bad
Pass / Fail Acceptance GateQualitative "Looks OK" or "Within Normal Range"Quantitative numerical corridor cited from revision in forceLog Category A/B defect; withhold retainage or permit
Custody & Sign-Off RecordSingle bundled "Accepted" signature at end of meetingScoped, dated sentence naming exact proved & unproved linesStrike unsupported claims; issue Conditional Refusal

2. Deep-Dive Technical Protocol and Field Implementation

The following field protocol—adapted directly from Volume 02: Read and Use Load Bank Data: A Field Guide to the Flash Report—establishes the step-by-step verification mechanics required on the data hall floor:

A flash report or automated chart is only as honest as the digital telemetry pipeline that populated its cells.

In modern megawatt-scale data center testing, telemetry does not magically appear inside a database. It makes a series of discrete, physical and digital hops: from a wetted immersion RTD element, through a local analog-to-digital converter (ADC), across an industrial Modbus-TCP fieldbus, through an edge collector gateway, and over an MQTT message broker into an immutable time-series store.

If any single hop in that chain fails silently—if an edge poller stamps a fresh timestamp onto an un-updated memory buffer, or if an MQTT broker publishes a cached "retained" message from yesterday—the resulting flash report is pure fiction.

This chapter defines the technical specifications of each hop, detailing the exact Modbus register structures, byte-ordering conventions, Quality Bitmask architectures, and MQTT payload schemas required to guarantee data integrity.

(See Figure 02 for the end-to-end telemetry hop architecture, the IEEE-754 word-swapping trap, the 16-bit Quality Bitmask register, and the standardized JSON payload schema).

Hop 1 & 2: Physical sensor to local transmitter

The journey begins at the physical process boundary:

At the transmitter, high-accuracy 24-bit Sigma-Delta ADCs sample the physical bridge at 1 kHz, applying a local digital moving average filter to output a calibrated reading once per second (1 Hz).

Hop 3: Modbus-TCP fieldbus architecture

The load-bank internal controller exposes its operational parameters over standard industrial Modbus-TCP (Ethernet Port 502) or Modbus-RTU (RS-485 serial bus operating at 115,200 baud, 8-N-1):

The IEEE-754 32-bit float byte-ordering trap

A single 16-bit Modbus register cannot store a 32-bit floating-point engineering quantity (such as a temperature reading of 45.12°C). Floating-point values require two consecutive 16-bit registers (4 bytes total).

Different microcontroller architectures implement different word-ordering conventions. If the edge gateway assumes the wrong word order, numbers will be completely corrupted:

The flash report's working setup sheet must cite the exact word-ordering convention used by the controller firmware. A temperature that suddenly jumps between seasons during commissioning is not an environmental miracle; it is an unverified word-swap parse error. Fix the parse in the edge gateway configuration; do not overwrite the raw incoming hex bytes.

The mandatory 16-bit Quality Bitmask register (Reg 40050)

A raw number without a quality flag is an unverified assertion. The load-bank controller must maintain a dedicated 16-bit Quality Bitmask Register (Register 40050) updated in real-time by internal firmware diagnostics:

If Register 40050 asserts Bit 4, 5, or 6, the edge gateway must immediately classify the reading as FAULT and log a missing gap, rather than publishing the corrupted number downstream.

Hop 4: Edge gateway active polling

The edge gateway runs a deterministic 1 Hz polling loop querying the load-bank Modbus controller:

Hop 5: MQTT telemetry broker and JSON schema

The edge gateway packages the live 1-second telemetry and publishes it to a local MQTT message broker:

dc/[hall_id]/[rack_id]/telemetry (e.g., dc/hall-03/lb-01/telemetry)

The JSON Telemetry Schema

Every message published to the broker must conform to a standardized JSON schema containing timestamp, electrical, hydraulic, and quality blocks:

{
 "timestamp": "2026-10-14T14:22:15.000Z",
 "rack_id": "LB-NVL72-01",
 "run_id": "RUN-2026-OCT-CX01",
 "commanded_kw": 120.0,
 "electrical": {
 "feeder_a_kw": 60.1,
 "feeder_b_kw": 59.9,
 "total_kw": 120.0,
 "voltage_v": 415.2,
 "current_a": 167.1,
 "pf": 0.999
 },
 "hydraulics": {
 "flow_lpm": 176.4,
 "supply_c": 35.08,
 "return_c": 45.12,
 "delta_t_k": 10.04,
 "dp_kpa": 112.5,
 "thermal_kw": 98.6
 },
 "companion_air": {
 "inlet_c": 24.2,
 "outlet_c": 38.5,
 "air_kw": 18.9
 },
 "quality": {
 "mask": "0x0007",
 "stale_flag": false,
 "raw_samples": 60
 }
}

Two Lethal MQTT Habits to Forbid

The pre-heat stale proof test

Before commanding heat on the day of the test, the test team must execute the Pre-Heat Stale Proof Test:

3. Field Verification Checklist and Instrumentation Hygiene

To execute this protocol without introducing measurement bias or scope ambiguity, the responsible engineer enforces four mandatory field rules:

Frequently Asked Questions (FAQ)

Why does "A failed poll is a gap" matter during high-density data center commissioning and operations?

Why liquid load bank commissioning data pipelines must record failed Modbus/OPC-UA polls as explicit NaN gaps rather than repeating stale cached values. When project teams bypass this rule to meet a commercial schedule milestone, unverified physical assumptions—such as hidden hydraulic pressure drops, unlogged polling gaps, unblanked bypass leakage, or uncalibrated sensor offsets—transfer directly into live 24/7 production as latent single points of failure.

How do you quantitatively verify compliance with "modbus telemetry polling gap detection" on the physical floor?

Compliance is verified by executing the governing mathematical balance (σT2 = 1 / N-1∑i=1N(Ti - T̄)2 ≡ 0.000000 K2 ⇒ \textttCHANNELFROZENSTALE) using independent, calibrated field instruments across a stabilized steady-state dwell window (minimum 15 to 30 minutes for thermal and hydraulic systems), and confirming that the discrepancy between primary and secondary measurements remains strictly within the pre-declared acceptance band.

What should an engineer do if a contractor or vendor submits a report that violates this protocol?

The reviewing engineer must refuse to sign the broad acceptance sentence, mark the specific line item as Unproved / Defective on the official audit sheet, and either require a witnessed re-test under a corrected script or isolate the unproved scope under a time-bounded Conditional Acceptance with a 150% to 200% financial retainage escrow holdback.

From Read and Use Load Bank Data: A Field Guide to the Flash Report, Tristan, Data Center Field Guides.

Related: One clock in the file.

FIELD PROTOCOL TAGS:
OFFICIAL FIELD MANUAL

Master the Complete Protocol: Read and Use Load Bank Data: A Field Guide to the Flash Report

1-Second Telemetry, Polling Gaps, Flow Balance Verification, and Delta-T Truth

Stop relying on contractor spreadsheets and vendor marketing claims. This field guide provides the complete, auditable verification binder—including physical equations, inspection stations, acceptance thresholds, and signed refusal templates.

Order Now:
Amazon Google Books Apple Books
Instant Digital Delivery • 7 High-Res Engineering Diagrams & Checklists
✓ Instant Digital Delivery • 7 High-Res Engineering Diagrams • Field Checklists
