FLAGSHIP GUIDE • VOL 03: Liquid Cooling Verification • 13 MIN READ

One liquid system at a time: First-Principles Data Center Engineering Protocol

Direct Answer Block: Why liquid cooling verification must execute static cleanliness flushes and zero-heat cold pump curves across every CDU and manifold before energizing load bank heaters. In mission-critical data center commissioning and operations, engineers enforce this boundary using deterministic physical equations, calibrated field instrumentation, and auditable sign-off gates rather than relying on vendor brochure summaries, uncalibrated software plots, or verbal assurances. Every measurement and state transition must be recorded with synchronized UTC timestamps and explicit pass/fail thresholds before a signature is granted.

One system before the integrated heat window.
One system before the integrated heat window.

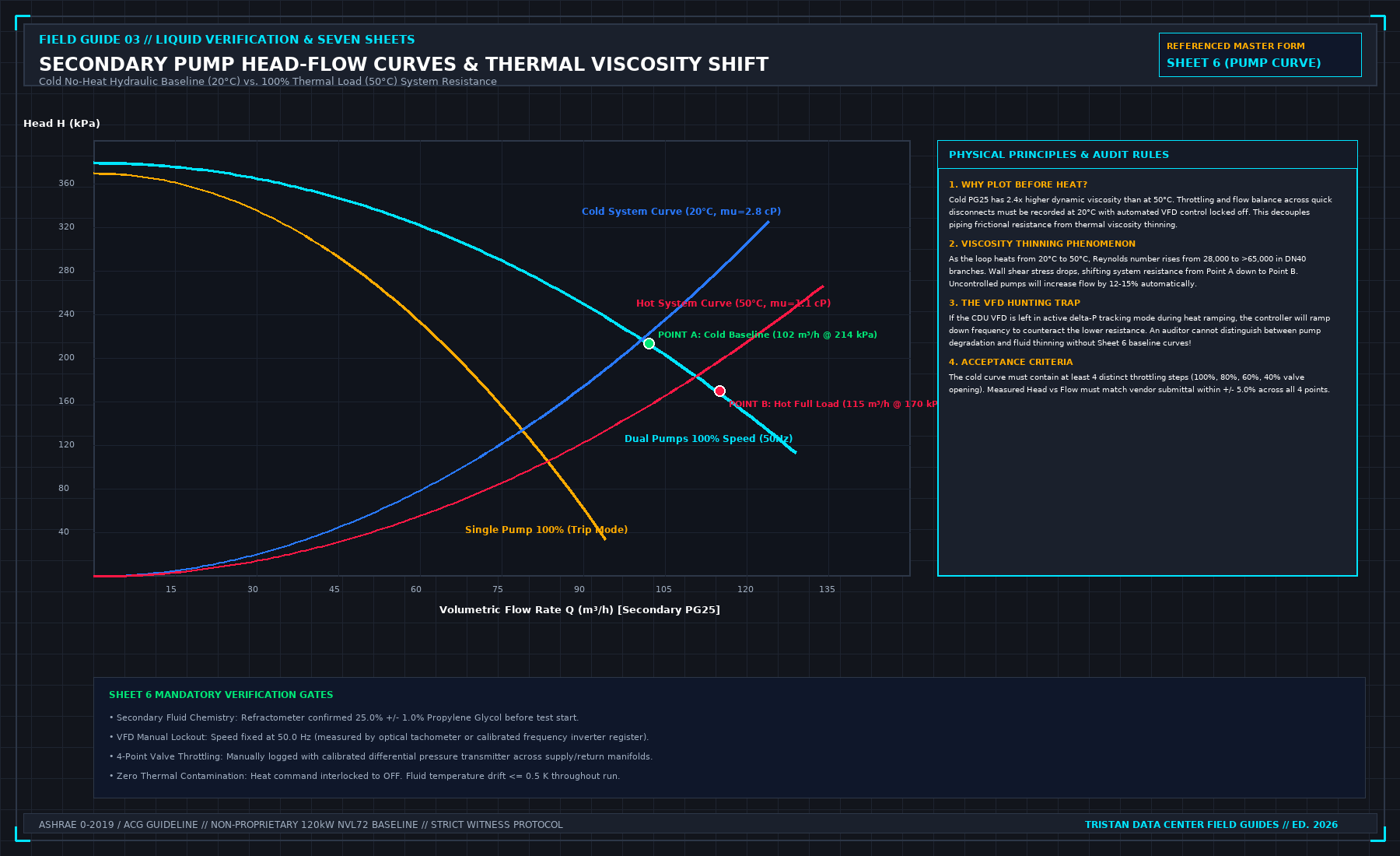

A liquid hall is more than one machine sharing pipes. If you heat the whole hall before one system has shown it can run, a failure has too many owners. The landed order that survives without site names is simple: survey, static checks, one system at a time, a no-heat pump curve, then the heat scripts, then shutdown, then the report.

The no-heat curve matters. It tells you the pumps and the path before energy confuses the picture. Skipping it because the schedule wants heat is how a flow problem is discovered as a temperature problem.

An open fail blocks the next stage. "We will watch it during heat" is not a close. It is a decision to run later with a known defect, and it needs a waiver that says what you will do if the defect appears under heat. A waiver without that sentence is permission to be surprised.

Do not mix a bad file with a plant fail. If the load bank file is not a valid test, that is not yet a punch item against the constructor. Separate the owners before you write the line.

1. First-Principles Engineering Formulation and Governing Mathematics

In high-density data center environments, verbal summaries and qualitative status tiles routinely obscure incipient physical failures. Whether auditing a 120 kW liquid-cooled rack boundary, evaluating a 1-second telemetry time series, or verifying plant redundancy prior to handover, the governing physical relationship for this protocol is expressed as:

Δ Psystem(Q) = Kloop · ρ(T) · Q2,      ρPG25(20^\circC) = 1030 kg/m3 → ρPG25(45^\circC) = 1018 kg/m3

When any term on the left-hand or right-hand side of this relationship is left unmeasured, inferred from an uncalibrated nameplate, or averaged across an unverified time window, the resulting engineering record cannot support a valid operational signature. Field engineers must verify each physical variable independently using NIST/ISO 17025 traceable instruments before proceeding to the next gate in the sequence.

Audit Verification ParameterUnacceptable / Defective Field PracticeAuditable First-Principles RequirementMandatory Action on Failure
Primary Boundary DefinitionImplied by vendor brochure or slide deckExplicitly bounded on stamped P&ID / SLD with tag IDsHalt acceptance; issue formal boundary clarification
Measurement & Telemetry ProofSingle uncalibrated display reading or 60-sec averageCalibrated Class A/0.5S sensor with 1-sec UTC timestampReject dataset; classify point as 0x40 Stale or 0x80 Bad
Pass / Fail Acceptance GateQualitative "Looks OK" or "Within Normal Range"Quantitative numerical corridor cited from revision in forceLog Category A/B defect; withhold retainage or permit
Custody & Sign-Off RecordSingle bundled "Accepted" signature at end of meetingScoped, dated sentence naming exact proved & unproved linesStrike unsupported claims; issue Conditional Refusal

2. Deep-Dive Technical Protocol and Field Implementation

The following field protocol—adapted directly from Volume 03: Finish a Liquid Cooling Verification: Seven Sheets for One Load-Bank Test—establishes the step-by-step verification mechanics required on the data hall floor:

Dynamic verification with multiple interconnected systems under thermal load is a later, integrated phase. This phase is dedicated to validating one machine at a time, executing the precise operational logic defined in its standalone test script while all adjacent systems remain quiet.

In the global commissioning hierarchy, this is Level 4 Functional Performance Testing (FPT). It validates the autonomous protection, modulating control loops, and physical alarms of individual machines before they are subjected to multi-megawatt thermal stress. Filing single-system testing under Level 5 Integrated Systems Testing simply because the equipment is physically located in the data hall is a serious documentation error.

Autonomous Coolant Distribution Unit (CDU) Verification

The Coolant Distribution Unit is the critical hydraulic interface separating the facility primary water system (FWS) from the secondary technology cooling system (TCS). Before any thermal load is applied by the load banks, the CDU must prove its ability to control fluid circulation autonomously under Script 04 and Script 05.

1. Pump Startup, VFD Modulation, and Soft-Start

Energize the CDU secondary pumps with the primary facility loop isolated. Execute controlled start and stop cycles:

2. N+1 Secondary Pump Auto-Changeover

Modern high-density CDUs employ an N+1 secondary pumping configuration (e.g., dual 100% capacity pumps, P-1A Lead and P-1B Standby). The automatic changeover logic must be verified through physical trip simulation:

3. Modulating Temperature Control Valve (TCV) Tracking

The primary loop Temperature Control Valve (TCV-101, typically a modulating 2-way or 3-way globe valve with an electronic actuator) regulates primary facility chilled water flow through the Plate Heat Exchanger (PHE-101) to maintain secondary supply temperature:

4. Secondary Differential Pressure Bypass Valve (BPV)

Inspect modulating bypass valve BPV-201, installed across secondary supply and return headers. Verify that as downstream manifold balancing valves are throttled, the BPV modulates open smoothly to maintain constant pump head, preventing impeller dead-heading.

BMS Telemetry and Field Instrument Point-to-Point Checks

Never assume that a value displayed on a Building Management System (BMS) screen or CDU human-machine interface (HMI) reflects physical reality. Every telemetry point defined in the project claim must undergo physical point-to-point cross-checking against calibrated field reference instruments:

POINT-TO-POINT TELEMETRY CALIBRATION AUDIT

TELEMETRY POINTBMS / HMI READINGFIELD CALIBRATED REFALLOWABLE DELTAAUDIT VERDICT
Secondary Supply T40.12 °C40.08 °C (PT100)+/- 0.30 KPASS
Secondary Return T50.25 °C50.15 °C (PT100)+/- 0.30 KPASS
Secondary Flow Rate115.4 m³/h116.1 m³/h (Ultrason)+/- 2.0%PASS
Secondary Supply P285.0 kPa282.5 kPa (Gauge)+/- 10.0 kPaPASS
Secondary Return P115.0 kPa118.0 kPa (Gauge)+/- 10.0 kPaPASS
Expansion Tank Level68.0 %67.5 % (Sight Glass)+/- 3.0 %PASS

If a discrepancy exceeds the allowable tolerance, the sensor offset must be recalibrated or the sensor replaced. Never adjust the acceptable tolerance band to match a drifting sensor.

Physical Hardware Alarm Injection

Alarms must be validated through physical hardware injection. Simulating an alarm by altering a software setpoint in a configuration file or toggling a bit in an engineering workstation is completely unacceptable. Software simulation proves that software can read a variable; it does not prove that the physical sensor, field wiring, and relay logic function under real-world conditions.

Execute physical alarm testing under Script 06:

THREE POSSIBLE AUDIT VERDICTS FOR AN ALARM

1. PASSAlarm physically injected at sensor; local annunciator active; BMS logged event with correct timestamp and description; interlock executed cleanly.
2. FAILAlarm injected but sensor failed to detect; delay exceeded tolerance; interlock relay failed to drop; logged immediately on Master Punch List.
3. NOT DEMONSTRATEDEquipment lacks the physical sensor, wiring, or software register to raise this alarm. Explicitly logged as "NOT DEMONSTRATED" on Sheet 2. Never "PASS".

If a specific alarm cannot be demonstrated because the hardware was omitted during construction, the line on Sheet 2 must be recorded as NOT DEMONSTRATED. Logging an untested alarm as "PASS" because "the vendor promised the logic works" is a serious professional breach.

The Level 4 Prerequisite Gate

Level 4 functional performance testing concludes when all single-system scripts are fully executed and signed. Any failed alarm injection, uncalibrated sensor, or hunting control valve must be formally resolved and re-tested before the facility advances to multi-system thermal testing.

3. Field Verification Checklist and Instrumentation Hygiene

To execute this protocol without introducing measurement bias or scope ambiguity, the responsible engineer enforces four mandatory field rules:

Frequently Asked Questions (FAQ)

Why does "One liquid system at a time" matter during high-density data center commissioning and operations?

Why liquid cooling verification must execute static cleanliness flushes and zero-heat cold pump curves across every CDU and manifold before energizing load bank heaters. When project teams bypass this rule to meet a commercial schedule milestone, unverified physical assumptions—such as hidden hydraulic pressure drops, unlogged polling gaps, unblanked bypass leakage, or uncalibrated sensor offsets—transfer directly into live 24/7 production as latent single points of failure.

How do you quantitatively verify compliance with "CDU cold pump curve commissioning before heat" on the physical floor?

Compliance is verified by executing the governing mathematical balance (Δ Psystem(Q) = Kloop · ρ(T) · Q2,      ρPG25(20^\circC) = 1030 kg/m3 → ρPG25(45^\circC) = 1018 kg/m3) using independent, calibrated field instruments across a stabilized steady-state dwell window (minimum 15 to 30 minutes for thermal and hydraulic systems), and confirming that the discrepancy between primary and secondary measurements remains strictly within the pre-declared acceptance band.

What should an engineer do if a contractor or vendor submits a report that violates this protocol?

The reviewing engineer must refuse to sign the broad acceptance sentence, mark the specific line item as Unproved / Defective on the official audit sheet, and either require a witnessed re-test under a corrected script or isolate the unproved scope under a time-bounded Conditional Acceptance with a 150% to 200% financial retainage escrow holdback.

From Finish a Liquid Cooling Verification: Seven Sheets for One Load-Bank Test, Tristan, Data Center Field Guides.
