FLAGSHIP GUIDE • VOL 03: Liquid Cooling Verification • 11 MIN READ

Certificate Level 1 is not a static test

Direct Answer Block: How to prevent numbering collisions between site test stages and ASHRAE Guideline 0 / Guideline 202 Commissioning Levels 1 through 5. In mission-critical data center commissioning and operations, engineers enforce this boundary using deterministic physical equations, calibrated field instrumentation, and auditable sign-off gates rather than relying on vendor brochure summaries, uncalibrated software plots, or verbal assurances. Every measurement and state transition must be recorded with synchronized UTC timestamps and explicit pass/fail thresholds before a signature is granted.

Certificate Level 1 is factory testing.
Certificate Level 1 is factory testing.

Commissioning certificates and site procedures often use the word level for different gates. In the certificate set, Level 1 is factory testing. Level 2 is delivery, installation, and pre-start. Functional testing and integrated testing sit later. Close-out is the last certificate, not the heat report.

A finished liquid hall often arrives with its own dialect. Static acceptance, no energy, gets called Level 1 because it is the first thing that team does on site. That label is locally clear and globally false. Drop the static report into the factory slot and you have certified a test you did not run.

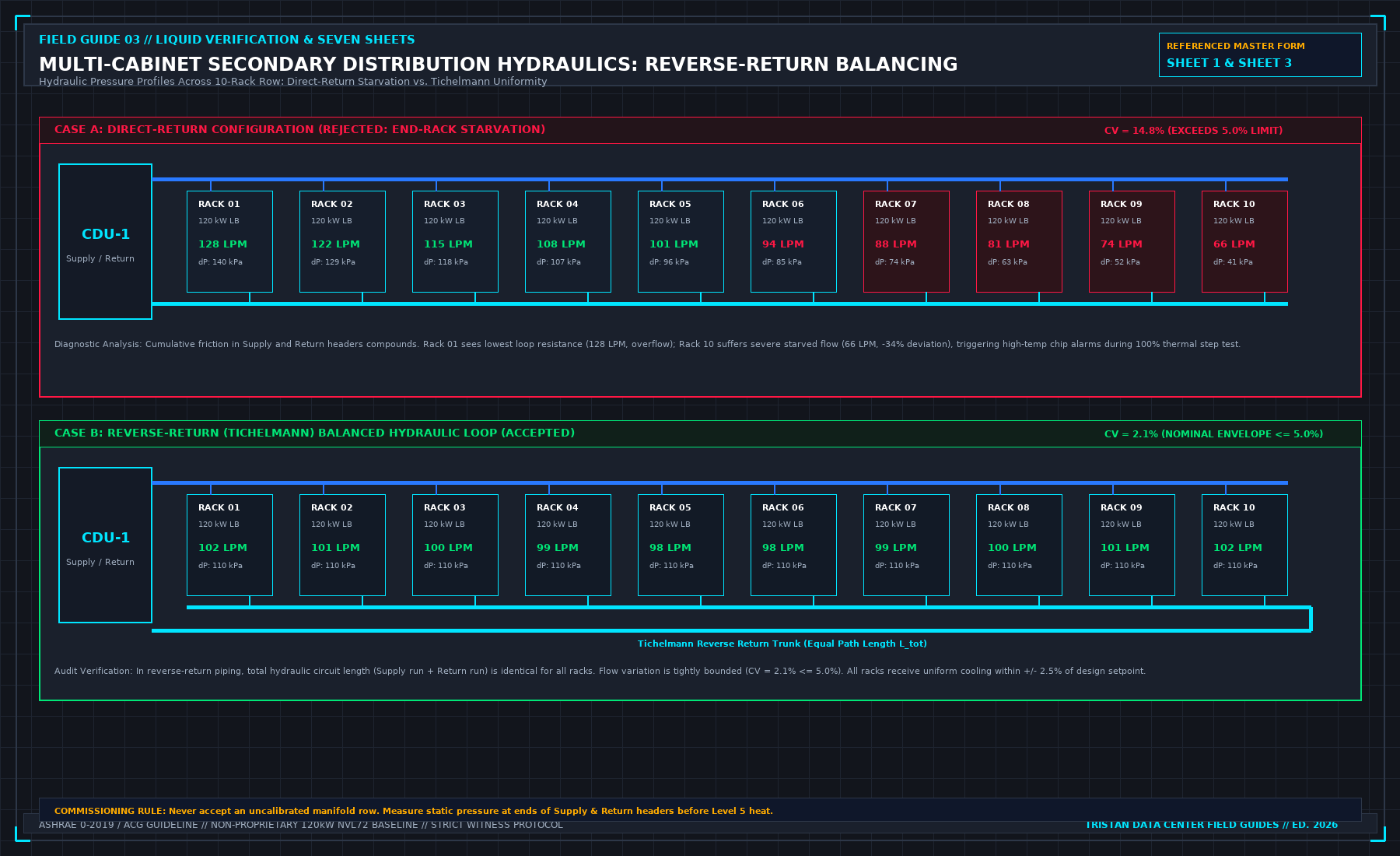

Write both maps on the first page, in a table a tired person can read at the door. Static work sits with pre-start, not with the factory. One machine at a time, if it is a functional test, is not "Level 1" on anything that will be signed. The heat window, more than one system, is integrated testing. Calling it a local stage 3 is harmless only if the cover says so, and the certificate does not.

A note that design and factory acceptance were left out is allowed. Reusing the words Level 1 for a different gate is not.

1. First-Principles Engineering Formulation and Governing Mathematics

In high-density data center environments, verbal summaries and qualitative status tiles routinely obscure incipient physical failures. Whether auditing a 120 kW liquid-cooled rack boundary, evaluating a 1-second telemetry time series, or verifying plant redundancy prior to handover, the governing physical relationship for this protocol is expressed as:

ASHRAE Level 1 (FAT) → Level 2 (QA/QC) → Level 3 (Pre-Start) → Level 4 (FPT) → Level 5 (IST)

When any term on the left-hand or right-hand side of this relationship is left unmeasured, inferred from an uncalibrated nameplate, or averaged across an unverified time window, the resulting engineering record cannot support a valid operational signature. Field engineers must verify each physical variable independently using NIST/ISO 17025 traceable instruments before proceeding to the next gate in the sequence.

Audit Verification ParameterUnacceptable / Defective Field PracticeAuditable First-Principles RequirementMandatory Action on Failure
Primary Boundary DefinitionImplied by vendor brochure or slide deckExplicitly bounded on stamped P&ID / SLD with tag IDsHalt acceptance; issue formal boundary clarification
Measurement & Telemetry ProofSingle uncalibrated display reading or 60-sec averageCalibrated Class A/0.5S sensor with 1-sec UTC timestampReject dataset; classify point as 0x40 Stale or 0x80 Bad
Pass / Fail Acceptance GateQualitative "Looks OK" or "Within Normal Range"Quantitative numerical corridor cited from revision in forceLog Category A/B defect; withhold retainage or permit
Custody & Sign-Off RecordSingle bundled "Accepted" signature at end of meetingScoped, dated sentence naming exact proved & unproved linesStrike unsupported claims; issue Conditional Refusal

2. Deep-Dive Technical Protocol and Field Implementation

The following field protocol—adapted directly from Volume 03: Finish a Liquid Cooling Verification: Seven Sheets for One Load-Bank Test—establishes the step-by-step verification mechanics required on the data hall floor:

This chapter prevents an accurate site test report from being filed into an audit binder as fraudulent documentation.

In global mission-critical data center commissioning, documentation is structured around seven standard completion certificate tiers. Simultaneously, local mechanical contractors frequently communicate using a colloquial "three-stage" vocabulary. When these two vocabularies are carelessly conflated, audit compliance collapses.

The Global Standard: Levels 0 Through 6

Modern commissioning frameworks (governed by ASHRAE Guideline 0-2019, ASHRAE Guideline 1.1, and the AABC Commissioning Group) define seven formal completion certificates:

The Local Dialect: Three Stages

On a retrofit project or a completed hall where a liquid verification team is mobilized specifically for a load-bank campaign, contractors routinely use an informal three-stage shorthand:

The stage sequence itself is logically sound: you do not energize equipment that has not passed static inspection, and you do not apply thermal load to a loop whose pumps have not been functionally proven. The hazard lies in the numbering.

The Compliance Trap

Contractors frequently label their Stage 1 static walk-through as "Level 1 Testing" in project folders. When an auditor or client compliance officer reviews the project binders, they open the tab marked "Level 1: Factory Acceptance Testing" and discover a clipboard checklist verifying that secondary hoses were unboxed and clamped to a manifold.

Filing a site walk-through into a factory acceptance binder is documentation fraud. Even if every checkbox on that site checklist represents diligent physical work, the certificate is invalid because Level 1 requires factory test bench data, factory calibration sheets, and manufacturing witness signatures.

To prevent this compliance breach, the first page of the Commissioning Plan must feature a prominent cross-reference matrix:

COMMISSIONING TIER TRANSLATION MATRIX

GLOBAL CERTIFICATE TIERLOCAL FIELD CONTRACTOR TERMMANDATORY VERIFICATION BOUNDARY
Level 0: Design AuditExcluded / AttachedOPR & BOD sign-off; design review waiver.
Level 1: Factory TestingFAT Vendor DocumentationFactory test records attached as evidence.
Level 2: Site Receipt QAStage 1 (Static Part A)Sheet 1: Unpack, megger, phase rotation.
Level 3: PFC & Start-UpStage 1 (Static Part B)Sheet 1: Flush, hydro-hold, fill and vent.
Level 4: Functional (FPT)Stage 2 (Single System)Sheet 2, Sheet 6, Sheet 7: CDU & alarms.
Level 5: Integrated (IST)Stage 3 (Heat Window)Sheet 3, Sheet 4: Thermal ladder & 2N pull.
Level 6: TurnoverCloseout HandoverSheet 5, Punch list clearance, Cx pack.

Mandatory Gating and Interlock Rules

A core tenet of commissioning governance is that no project may advance across a level boundary while unresolved defects exist in the preceding tier:

If an owner chooses to waive an open defect to maintain an aggressive project schedule, that waiver must be documented as a formal written deviation signed in ink by the Owner’s Project Engineer. The waiver must explicitly define the compensatory safety controls deployed on site. An informal verbal agreement is completely invalid.

3. Field Verification Checklist and Instrumentation Hygiene

To execute this protocol without introducing measurement bias or scope ambiguity, the responsible engineer enforces four mandatory field rules:

Frequently Asked Questions (FAQ)

Why does "Certificate Level 1 is not a static test" matter during high-density data center commissioning and operations?

How to prevent numbering collisions between site test stages and ASHRAE Guideline 0 / Guideline 202 Commissioning Levels 1 through 5. When project teams bypass this rule to meet a commercial schedule milestone, unverified physical assumptions—such as hidden hydraulic pressure drops, unlogged polling gaps, unblanked bypass leakage, or uncalibrated sensor offsets—transfer directly into live 24/7 production as latent single points of failure.

How do you quantitatively verify compliance with "ASHRAE Guideline 0 commissioning levels 1 to 5" on the physical floor?

Compliance is verified by executing the governing mathematical balance (ASHRAE Level 1 (FAT) → Level 2 (QA/QC) → Level 3 (Pre-Start) → Level 4 (FPT) → Level 5 (IST)) using independent, calibrated field instruments across a stabilized steady-state dwell window (minimum 15 to 30 minutes for thermal and hydraulic systems), and confirming that the discrepancy between primary and secondary measurements remains strictly within the pre-declared acceptance band.

What should an engineer do if a contractor or vendor submits a report that violates this protocol?

The reviewing engineer must refuse to sign the broad acceptance sentence, mark the specific line item as Unproved / Defective on the official audit sheet, and either require a witnessed re-test under a corrected script or isolate the unproved scope under a time-bounded Conditional Acceptance with a 150% to 200% financial retainage escrow holdback.

From Finish a Liquid Cooling Verification: Seven Sheets for One Load-Bank Test, Tristan, Data Center Field Guides.

Related: Close-out is not a heat-test report.

FIELD PROTOCOL TAGS:
FIELD MANUAL 03 • IN PUBLISHING

Master the Complete Protocol: Finish a Liquid Cooling Verification: Seven Sheets for One Load-Bank Test

ASHRAE Guideline 0 Levels 1-5, Integrated Systems Testing (IST), and Contractor Pass Separation

Stop relying on contractor spreadsheets and vendor marketing claims. This field guide provides the complete, auditable verification binder—including physical equations, inspection stations, acceptance thresholds, and signed refusal templates.
